Quick Answer: A home renovation in Burlington usually runs between $30,000 and $150,000, depending on how much of the house you touch. Permits are issued by the City of Burlington under the Ontario Building Code. Mid-size projects take six to fourteen weeks once demolition starts.
Is a Home Renovation in Burlington Right for You?
A home renovation in Burlington earns its keep when your layout stopped matching how you actually live, or when wiring, plumbing, and windows are near the end of their service life. Cosmetic updates can wait a year. Mechanical problems get more expensive every season you postpone them.
Serving Burlington and the surrounding Halton neighbourhoods of Aldershot, Alton Village, Millcroft and Roseland, most work here splits into two categories. Older homes built between the 1950s and 1980s need systems brought up to current code. Newer builds in the north end are usually chasing finishes and better use of space.
Ask yourself one question. Are you fixing something, or changing something? Fixing is maintenance and it rarely moves your resale number. Changing the plan of the house is where the money and the value both live.
What Drives Home Renovation Cost in Burlington?
Home renovation cost comes down to four things: square footage touched, whether you move plumbing or load-bearing walls, the finish tier you pick, and how much surprise repair hides behind the drywall. Two identical kitchens can differ by $40,000 on finishes alone.
Labour in the Halton and Hamilton corridor sits at the higher end of the Ontario range because trades are pulled between Burlington, Oakville and Toronto projects. Book winter starts if you can. Spring and summer are when contractor calendars tighten and pricing firms up.
| Project scope | Typical Burlington range | Timeline |
|---|---|---|
| Single bathroom | $18,000 to $35,000 | 3 to 5 weeks |
| Kitchen (same layout) | $35,000 to $70,000 | 6 to 10 weeks |
| Kitchen (moved plumbing, custom cabinetry) | $70,000 to $120,000 | 10 to 16 weeks |
| Finished basement | $45,000 to $90,000 | 8 to 12 weeks |
| Full interior, 2,000 sq ft | $150,000 to $300,000 | 4 to 8 months |
Hold back 15 percent of your budget as contingency. Knob-and-tube wiring, undersized electrical panels, and asbestos in old vermiculite insulation are the three findings that most often blow a Burlington budget, and none of them show up in a quote until walls are open.
Which Rooms Are Worth Renovating First?
Kitchens and bathrooms return the most per dollar spent, because buyers price them the hardest and because both rooms carry plumbing and electrical work that is cheaper to do once than twice. Start where the house is failing, then spend what’s left on the rooms people photograph.

Kitchen renovation Burlington homeowners actually use
A kitchen renovation Burlington homeowners are happy with two years later almost always changed the traffic flow, not just the cabinet doors. Widening a galley, pulling out a peninsula, or moving the sink to the window wall changes daily life more than a stone upgrade does.
Cabinetry eats 30 to 40 percent of a kitchen budget. If your boxes are solid, refacing them and putting the savings into counters, appliances and better lighting is a legitimate strategy. Our kitchen renovation services in Burlington page walks through both routes.
Bathroom remodeling and wet-area details
Bathroom remodeling lives or dies on waterproofing. Membrane behind the tile, proper slope to the drain, and an exhaust fan vented outside the roof rather than into the attic. Skip any of those and you’re paying twice inside five years.
Second-floor bathrooms in older Burlington homes often need the subfloor rebuilt before tile goes down. That’s a $2,000 to $4,000 line item nobody budgets for.
What Does an Interior Renovation in Burlington Include?

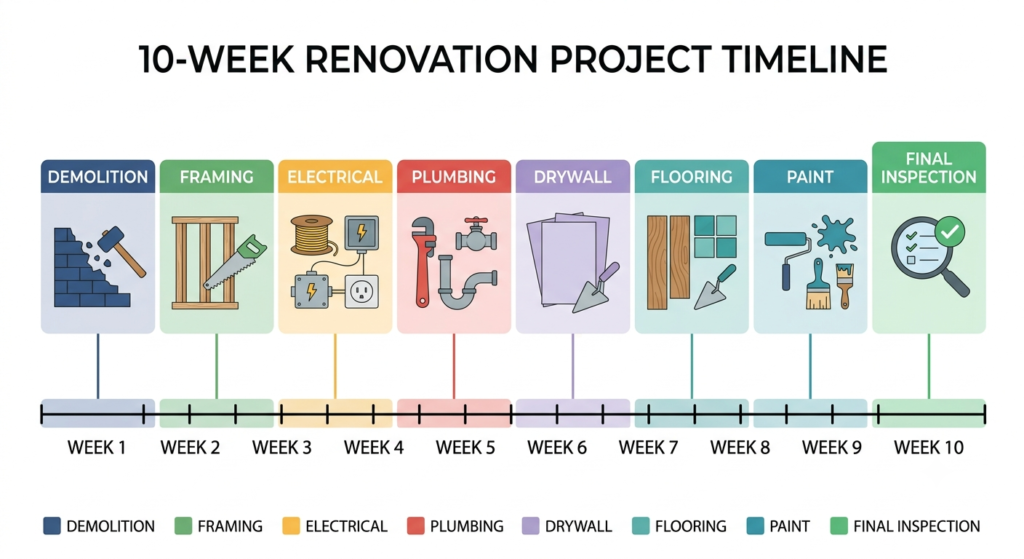

An interior renovation Burlington project typically bundles several trades under one schedule: framing, drywall, flooring, trim and paint, plus whatever electrical and HVAC the new layout demands. The value of bundling is sequencing. One crew waiting on another is what turns a ten-week job into a five-month one.
Basement renovation and headroom limits
A basement renovation in Burlington hinges on ceiling height and moisture. Many pre-1970 basements sit at 7 feet or less, which limits what you can legally call habitable space and rules out dropped bulkheads for ducting. Underpinning or benching solves it, but adds serious cost.
Check for efflorescence on the block walls before you frame anything. White powder means water is moving through, and framing over it just hides the problem. Read more on scope and sequencing in our interior renovation guide.
Flooring installation and painting services
Flooring installation should be one of the last steps, after drywall dust settles and before trim goes on. Engineered hardwood handles Ontario’s humidity swings better than solid plank on a concrete slab. Ask about acclimation time. Boards need days in the space before they go down.
Painting services are the cheapest way to change how a finished renovation reads, and the easiest place to see whether your contractor cared. Look at the cut lines where wall meets ceiling.
Do You Need a Permit for Renovations in Burlington?
Yes, for most structural, plumbing, electrical and HVAC changes. Permits come through the City of Burlington building department and are reviewed against the Ontario Building Code. Painting, flooring and cabinet swaps generally don’t require one.
Removing a wall almost always does, even when it looks non-structural. So does finishing a basement, adding a bathroom, or changing a window opening size. Electrical work is separately governed by the Electrical Safety Authority.
Unpermitted work surfaces during resale, and it complicates insurance claims. Fix it before you list, not during.
How Do You Hire the Right Renovation Contractor?
- Confirm WSIB clearance and at least $2 million in liability coverage. Ask for the certificates, not a verbal yes.
- Get three quotes broken down by line item. A single lump sum tells you nothing you can compare.
- Visit one finished project and one active site. Active sites tell you more.
- Read the change-order clause before signing. It decides who pays when the unexpected shows up.
- Register the HST number and check it. Cash deals leave you with no warranty and no recourse.
Payment schedules should follow milestones, never dates. Deposits above 15 percent at signing are a warning sign in this market. When you’re ready to scope your project, our team handles renovation planning across Burlington and Halton.

Frequently Asked Questions
1. How long does a home renovation in Burlington take?
Single-room projects run three to six weeks. Kitchens take six to sixteen weeks depending on cabinetry lead times, which are the single biggest scheduling variable. Whole-home interior renovations run four to eight months. Add four to eight weeks upfront for design, quoting and permit review.
2. Do I need to move out during a renovation?
It depends on scope and water access. You can usually stay for a single bathroom or a basement. You should plan to leave if:
- The kitchen is out of service for more than three weeks
- The only bathroom is being gutted
- Furnace, main plumbing stack, or electrical panel work is happening
- Asbestos or lead abatement is required
- Second-floor framing is being altered
3. Is a kitchen or bathroom renovation a better investment?
Kitchens return more in absolute dollars because they carry more of a buyer’s impression of the house. Bathrooms return a higher percentage of what you spend, since the rooms are small and the budgets are lower. Do the one that’s failing first.
4. Are there government rebates for renovations in Canada?
Federal and provincial programs for insulation, heat pumps, and windows change regularly, and eligibility usually requires a pre-retrofit energy assessment before work starts. Check current offerings through Natural Resources Canada rather than relying on a contractor’s summary, because program windows open and close without much notice.
5. What should a renovation quote include?
A quote should list scope by room, material allowances with dollar amounts, exclusions, permit responsibility, a payment schedule tied to milestones, a written warranty term, and the change-order process. Anything described only as “allowance” without a number is a gap you’ll pay for later.
Conclusion
A successful home renovation in Burlington is decided before demolition day, in the quality of your scope document and the contractor you sign with. Budget the contingency. Pull the permits. Sequence the trades so nobody waits. Get those four right and the finishes take care of themselves.
